| Understanding and Running a Successful ProjectAs projects become larger and more complex, the effective management of them
 becomes proportionally more significant. For these projects, the consequences
 of decisions on, essentially, how well the project is to be managed, with commitment
 to communication and coordination, will generally far outweigh the consequences
 of how well a specific technical role is performed. The tighter the schedule,
 the more this need is magnified. The required skills are thus quite different from the technical design, engineering
 or construction skills usually associated with most projects. Indeed, on a large
 complex project there are aspects outside of the scope of these technical areas
 that have to be well managed, if the project objectives are to be met. For this
 reason, great emphasis must be placed on the project management team approach,
 backed by broad based specialized resources. 2.1 The Keys to SuccessThe key to the successful management of any large project is therefore highly
 dependent upon the following:
 A demonstrated leadership through a management organizational form capable
  of providing effective planning and managementThe use of a project management system as a model for management philosophy
  and strategyThe use of proven, contemporary project management theory and practice in
  planning, organizing, leading and controlling the use of project resources In the last analysis, the test of effective project management is the degree
 to which the project objective has been accomplished on time and within budget
 to the satisfaction of the "stakeholders". This means working with people to achieve results. This is especially true
 of highly technical and complex environments such as those involving modern day
 construction projects. Consequently, it is essential that the project manager
 and his team are sympathetic to, and comfortable with, their cultural and organizational
 environment. Therefore, let us first consider the traditional corporate management
 environment. 2.2 Traditional Corporate Management Traditionally, management education has not been concerned with projects but
 with the running of an on-going enterprise. Time is not an immediate concern.
 Change is minimal and protracted, and hence can be thoroughly programmed and
 progressively integrated. The work places of such enterprises are bounded by
 traditional hierarchies, lines of authority, centralized control and repetitive,
 assembly-line type jobs. Unfortunately, this traditional corporate management approach breaks down where
 projects are concerned. Consequently, new management relationships are required,
 which tend to cut across the normal flow of authority and responsibility and
 radiate out side of the functional unit. Happily, project management is a much
 more exciting and challenging work environment, even though a clear understanding
 of its concepts is relatively new. This is because Project Management is a different type of management
 applied to project-type work. However, associated with almost all capital projects
 are many people who are not trained in the process of bringing a capital project
 on stream. Without embarrassment, I include politicians, owners, sponsors, financiers,
 bankers, operators, lawyers, accountants and, I regret to say, even engineers. Thus, it is essential to establish competent Project Management capability
 long before even putting in place appropriate design, engineering or construction
 capability. But first let us understand the project manager's organizational
 environment. 2.3 The Project Manager's Organizational Environment Typically, the project group to be managed will consist of consultants, contractors,
 specialists, the staff of the owner and the project control team itself. A typical

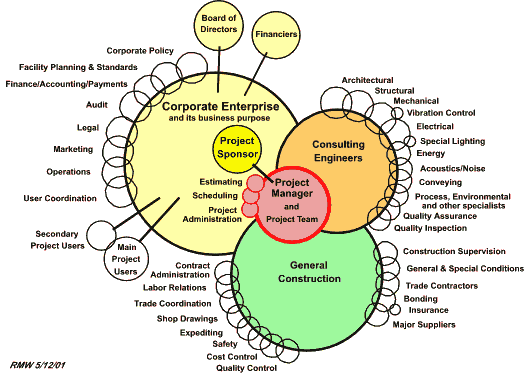

 situation is shown in Figure 1. Each unit or person in
 the group has two allegiances or "bosses", the project manager and
 his "home" department or firm. This dual reporting relationship is
 often referred to as a "matrix" structure and accounts for much of
 the complexity of project management on a large project. Figure 1: Project management in a corporate environmentIdeally, the project manager will receive an "Authority" or "Mandate"
 from the project's "Executive", i.e. the party that has the authority
 to approve further project funding. This mandate should be to direct all operational
 activities including planning, design, procurement, construction and commissioning.
 As such, he will have requirements for such project support activities as estimating,
 forecasting, scheduling, procurement, project accounting, and progress reporting. In addition, on a larger project, he will require other more specialized services
 such as financial accounting, payroll, systems development, personnel, legal,
 public relations and property acquisition. Because they do not normally affect
 project control decisions, these activities are usually carried out by independent
 departments or companies, not under the project manager's direct supervision.
 Nevertheless, if the project manager is to get the quality of information and
 service that he needs, he must maintain good communications with all such parties. The project manager will also be required to report to the Executive on a regular
 basis. For this he must render a succinct digest of the available information
 on progress, forecast, resource requirements, and actions required. In contrast, the Executive's interest will tend to focus on expenditure to
 date, forecast final cost, and the scheduled commencement of the facility. 2.4 Project Phases As shown in Figure 2, there are four distinct project

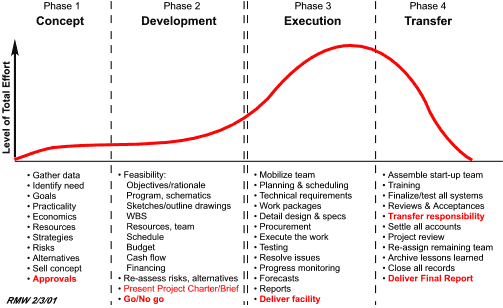

 periods which make up the typical project life span. Figure 2: Project Life Span: Four Basic PeriodsæThese four basic periods are:
 Concept - for developing the project parameters in outlineDevelopment - of the plan and design and definition of the facilityExecution of the planTransfer of the completed facility over to operations.  These periods or phases may be more easily remembered by the letters C-D-E-F
 standing for: Conceive Develop Execute andæFinish. Figure 2 also shows typical activities which are required
 in each phase for building, say, a hydro electric facility or a process plant.
 Of special significance is the variation in the level-of-effort (LOE), which
 is associated with these activities, and which is required to conduct a project
 through its life span. Note especially that "approvals" are called
 for at the end of each of the first two phases. These are really like "gates"
 between major phases of the project, also known as "major milestones",
 or "Executive Control Points". 2.5 Executive Control PointsEvery project should have Executive Control Points acting like closed gates
 which only open following Executive Approval, see Figure 3.
 At these points, the project manager presents certain predetermined "deliverables"
 to the Executive that will enable them to make an informed decision on a "go"
 or "no-go" basis for further work.

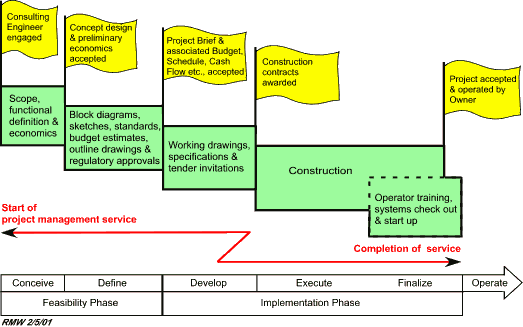

 Figure 3: Project Life Span Control GatesIt must also be emphasized that it has been estimated that it costs about ten
 times as much to implement a change in each succeeding phase. Hence, during construction,
 changes (and consequent delays) will cost ten or more times as much to implement,
 compared to making the same changes during the planning phase. Therefore, these points provide the opportunity for the Executive to exercise
 a high level of control over the shape and timing of the project. The Executive
 can thereby ensure that either the project is developing in a manner consistent
 with their objectives, or the project can be modified with minimum upset if the
 objectives have changed. It is also the opportunity for the Executive to provide
 a morale boost by injecting enthusiasm, excitement and discipline into the project
 team. Equally, these formal approvals provide the project manager with his authority
 to drive the project through to the conclusion of the ensuing phase. It is also
 his opportunity to ensure that the Executive is behind him and that he is proceeding
 in the right direction. Undoubtedly, the most important control point in the project life cycle is
 reached at the conclusion of the development phase because this marks the project's
 transition from feasibility to implementation. At this point, a project "go"
 decision must be based on sound and well documented information. This information
 should be presented in a comprehensive document referred to as the Project Brief.
 It is the means whereby the Executive know precisely what they are getting. 2.6 Project Brief The Project Brief, when approved, becomes the prime source of reference for
 the project implementation phase. A good Project Brief will include:
 Executive summaryGeneral statement of business aims and objectivesTechnical approachStatement of project scopeRegulatory approvals and requirementsPreliminary design sketches, block diagrams, standards; o project team organizationImplementation scheduleProcurement planProject estimate and proposed appropriation budgetOther resources required from the sponsoring organization (e.g., land, space,
  staff, etc.)Financial statement and economic projectionsCash flow projectionJustification, alternatives; andAreas of uncertainty and risk.  2.7 Project Management Functions The management functions involved in a project typically include scope, quality,
 time, cost, risk, procurement of human and material resources, and communications
 management. Each represents a separate discipline calling for special training,
 and the requirement for each function depends on the size and nature of the project
 in question. These functions are now considered to be part of the "Project
 Management Body of Know ledge" or PMBoK as it is called, as developed by
 the Project Management Institute. This subject is discussed in rather more detail in Section
 4. A copy of the PMBoK is available from the Project Management Institute,
 in Pennsylvania, U.S.A.. However, the functional descriptions given in Appendix
 A will be more familiar to construction people. 2.8 Project Control CycleThe basic cycle of management control can easily be remembered by the mnemonic
 "POEM" standing for: Plan, Organize, Execute,
 Monitor-and-control. Plan - The first step is to plan the project with respect to
 scope, quality, time and cost. What precisely is to be done? Why? If it is, say,
 a new plant, what is the purpose and process in the plant? How is the job to
 be done? Why should the project be done one way rather than another? Indeed,
 why should it be done at all? Where is it to be built? Who will design and construct
 it? What resources in terms of materials, manpower, finances and time are required?
 What risks are involved? What strategies are required to deal with unplanned
 occurrences? Organize - The second basic step is an extension of the first.
 A careful analysis must be made of the various activities required in planning
 and executing a project, to provide a closely related project team structure.
 For every project activity (e.g. programming, estimating, design, planning, procurement,
 construction) there must be a very clear definition of who is responsible, and
 who has the authority to execute that activity. That person must also have a
 very clear idea of its scope, quality, time and budget. Execute - The methods by which the Plan is executed or implemented
 are critical. No project manager (or other member of the project team) will be
 successful unless he understands the basic needs of human beings, their strengths
 and weaknesses, mental and social abilities, and how to weld a complex mixture
 of humans into a dynamic and productive team. The single most important characteristic
 of a successful project manager is his ability to manage people. Monitor and Control - Continued monitoring, reporting and fore
 casting must take place during project implementation, and the forecasts compared
 to the Plan. Deviations must immediately receive management attention, either
 by reallocation of resources or modifications to the Plan (with Executive approval
 if the project objectives are affected). Without a detailed Plan, there is no
 baseline for comparison, no determination of deviation, and hence no satisfactory
 basis for corrective action. Clearly then, a successful project management system is one which monitors
 and responds by a control action as early as possible after an event. Figure

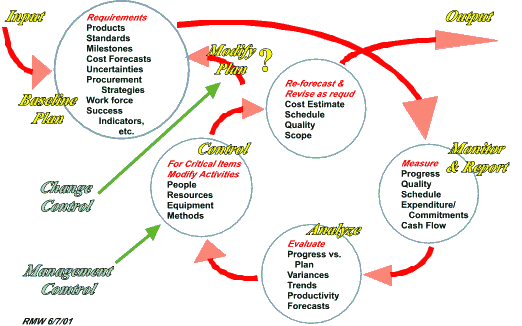

 4 shows the elements of a project control system.
 Figure 4: Elements of a project control system2.9 Function-Process-Time RelationshipæThe relationship between the functional components, the control process and

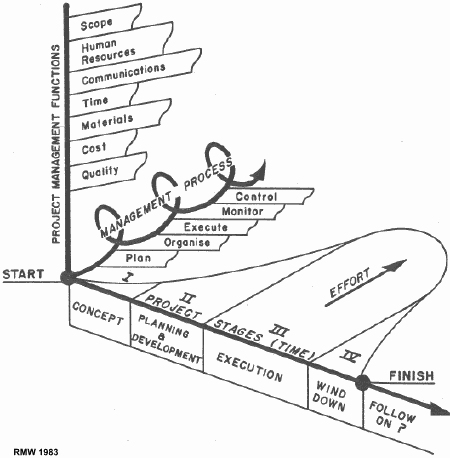

 the project phases may be viewed as three-dimensional. This relationship is shown
 in Figure 5. The project life cycle is shown on the X axis with its classic four generic
 project phases, together with the typical variation in level-of-effort with which
 they are generally associated. On the Y axis are the major project functions
 to be managed, which in fact I believe apply to anyæ project, although
 they may vary in importance according to the field of application (industry).
 In other words, if project management is not paying attention to each and every
 one of these, then they are not so likely to get the best out of the project.
 On the Z axis is shown the traditional high frequency input-process-output-feedback
 control cycle. æThe point is that this control cycle has to be applied to every one of the
 major functions as each of the latter are progressively "managed" through
 the project life cycle in order to reach the project's goals and objectives successfully.
 Figure 5: The Function-Process-Time relationship2.10 Project Manager's ObjectivesæIt follows from the foregoing that the Project Manager's personal objectives
 must be to:
 Attain the willing commitment of people to assigned tasks Achieve the coordination and collaboration of different work groups, responsibility
  centers, and entire organizations, including those of the ownerAchieve cooperation by placing a high premium on reliability and timeliness
  of information, and by discouraging unnecessary or irrelevant informationSteer the project to completion in an orderly and progressive mannerEnsure that trade-offs between scope, quality, time and cost are satisfactory
  and acceptable, and are seen to be so, andEncourage the development of personal and professional skills amongst the
  project participants 2.11 Work Breakdown StructureThe process of project control described earlier requires the establishment
 of a firm base line defined in terms of scope, quality, time and cost on a compatible
 basis, and in units that can be more readily handled. One of the more important
 and powerful techniques for managing a large complex project, therefore, is the
 Work Breakdown Structure (WBS), which greatly facilitates control. A Work Breakdown Structure (WBS) is a task-oriented "family tree"
 of activities, which organizes, defines, and graphically displays the work to
 be accomplished. By means of a WBS the scope of the project can be broken down into a suitably
 coded structure that identifies manageable segments with clearly assigned responsibilities.
 See Figures 6a, b, and c
 for a typical example.

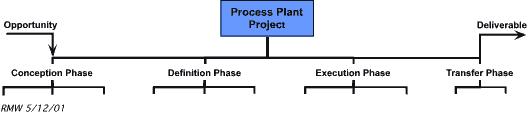

 Figure 6a: Top level of a process plant project WBS

 Figure 6b: Detailed WBS for the Conception and Definition phasesTo be effective a WBS must:
 Establish an information structure for describing the project's scope in
  entirety Serve as an effective means of communication to integrate the objectives
  and activities of all the internal and external organizations involved in the
  project Represent the planning of the project, step by step Separate sequential and parallel activities assigned to different groups
  who will schedule, measure and control their own performance, and Reflect the procurement strategy during the various stages of the project's
  life cycle
 Figure 6c: Detailed WBS for the Execution and Transfer phasesIn practical terms this WBS and corresponding coding also requires:
 Early implementation Flexibility and expandability Universal application Simplicity, and Capability of summation.  The "manageable segments" of the project referred to above, are called
 Work Packages. Thus, a Work Package describes the work to be performed by a specific
 organizational unit, and serves as a vehicle for monitoring and reporting on
 progress, cost and schedule. See Appendix B for essential rules. All work packages fall into one of three different categories, namely:
 Discrete Tasks which have a specific end result or objective. These normally
  cover 60 to 75 percent of the total work in a project.
 Apportioned-effort Tasks which can be directly related and apportioned to
  discrete tasks. Examples include quality control or inspection. These tasks
  are required in support of the discrete tasks, and hence, their schedule and
  budget can be related to the discrete tasks.
 Level-of-effort Tasks which have performance standards rather than specific
  end results. These consist mainly of the overhead accounts, e.g., management,
  administration, liaison, coordination, etc. These tasks are characterized by
  relatively level, time-phased budgets and are not time-limited as in the case
  of the discrete tasks.  2.12 Prerequisites for a Successful ProjectThe Project Executive has a vital role to play and should insist on the following: Executive Support - The Executive must clearly demonstrate support
 for the project management concept by active sponsorship and control. External Authority - The project manager must be seen as the
 authoritative agent in dealing with outside parties, and be the responsible and
 single formal contact with them. Internal Authority - The project manager must have the necessary
 managerial authority within his organization to ensure response to his requirements. Commitment Authority - The project manager should have capability
 and authority to control the commitment of funds within prescribed limits. Competence - The project manager and his team members must be
 competent. Other functional personnel assigned to the project must also be competent. Project Team - The project manager should have a say in the assembly
 of his project team, which will help him to obtain their personal commitment.
 The private sector should build up the best source of expertise. Project Manager Involved in All Major Decisions - No major technical,
 cost, schedule, or performance decisions should be made without the project manager's
 participation. Management Information Systems - Effective project management
 information and control systems must be in place, preferably with third party
 observation, scheduling and estimating resources. While the foregoing do not necessarily guarantee success, their absence will
 certainly make success more difficult to attain.
 |
