Leadership and the Project Life Cycle
It is clear that leadership is important to the success of a project because
leadership is essentially about motivating people. It is also clear that what
may be characterized as "managership" is equally important because
this is about getting things done. Can the two be reconciled? For this it is
necessary to turn to a fundamental principle underpinning the concept of project
management.
Project management is a structured but flexible process for producing a new
end result. Its success depends on the application of a two step sequence: First
plan - then produce. This is the genesis of every successful project life cycle.
For example, in the "planning" phases of a project, the project leader
conducts the project team and other main stakeholders through formal and informal
decision making in order to achieve agreed goals and objectives. This process
involves a high degree of interaction and formulation of organizational strategies.
It takes time and is challenging. The development of the resulting technical
requirements may require a number of iterations and re-runs. This is especially
true at the outset, in order to flush out the "customer's needs". Therefore,
"visioning", "intelligence gathering" and developing "a
compelling reason" and "appropriate strategies", are the all-important
issues. These issues also form the essential basis for effective team development.
In this, project management is near-unique. For while a CEO or other enterprise
leader may develop his "team" once (or so) in his/her tenure, the project
leader must be conscious of the "Project Team Development Cycle" for
every project and throughout the project life cycle.
Thus, planning is about optimizing the effectiveness of the project and its results,
i.e. "doing the right things".
On the other hand, the real work of task execution gets done in the "producing"
phases. In these phases, the paramount requirement is an ability to satisfy the
customer(s) by conducting the efforts of the project team towards the required
product(s) under typical project constraints. This is achieved by consistently
"getting the message out", which also provides the essential basis
for project control. Thus, producing, or management of production, is about optimizing
the project process, i.e. "doing the things right".
To get a project off to a good start, the project manager must be a leader,
but this style of leadership does need to change as the project progresses through
its life cycle. Indeed, there comes a point in time when "managership"
is more important than "leadership". It will be observed that "information"
(intelligence gathering) in the planning phases, and "communications"
(getting the message out) in the producing phases, i.e. intercommunication, is
an essential skill for both the project leader and the project manager. Table
2 shows this progression from leader to manager in greater detail.
|
Phase
|
Major Attributes/Emphasis
|
Leadership Style/Blend
|
|
Feasibility Study
(Pre-formulation)
|
Sense of vision
"Big Picture" (conceptual)
Analysis
|
Visionary
Creates future
Empowerment
Expansive
|
|
Conceptual
(Formulation)
|
Listening
Analysis
Alignment
|
Analytical
Listener
Change master
Convergence
|
|
Development
|
Participative/Acceptance
and commitment
Cooperative
|
Team builder
Power and influence
Integrator
|
|
Execution
|
Re-alignment
|
Decision maker
Balances work and fun
Trustworthiness
Team and synergy
|
|
Finishing
|
Transfer of product and information
|
Administrator
Closure
|
Table 2 ø Leadership and the project life cycle
In Figure 3 we shows how the progression in Table
2 relates to the typical major tasks of the project life cycle, and corresponding
organizational strategies.

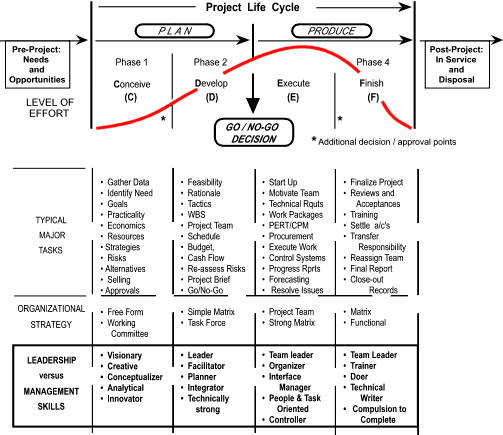

Figure 3: The evolution of tasks and people through the project life cycle
|
